Full Sail Partners Blog | Rana Blair

Posts by Rana Blair:

Easily Change Project Plan Dates and Hours with Deltek Vantagepoint

Posted by Rana Blair on May 18, 2022

2022 - Redistribute Planned Hours-01

For professional services firms, projects often don’t go according to the original plan. This forces the project manager to spend time updating the project plan to reflect new project dates, adjusted hours, and resources needed to complete the project. With Deltek Vantagepoint, this doesn’t have to be a burden on the firm’s project managers. These changes are easily and automatically made, allowing the firm to focus on serving clients instead of constantly updating plans.

Typical Project-Based Firm Planning Scenario

Let’s say the Natural Sciences Building at Northwest project was originally scheduled to take place from January 2021 through September 30, 2021. The phases at the beginning were Master Planning and Project Management. Then the project goes on hold for a few months, which happens often for project-based firms. Now, the project is restarting with a new phase in a new date range. The project manager wishes to set a proper baseline on the original schedule, and then review the new plan against the baseline.

Let’s walk through each of these steps separately. Then, at the end, learn about how to see this in action.


Changing Project Plan Dates at Various Project Levels

Changing the plan dates is always the first step. To change the dates at a phase level, click the ‘kabob’ at the far right of the phase and select the Reschedule dialogue. Using this tool, users can shift the entire phase to the left or right or change the duration by dragging it longer or shorter.

For this example, the new duration for the Sustainability Planning phase will begin on March 1, 2021, and end on July 31, 2021. At this point, Vantagepoint will ask to replace the child dates – those dates of the individual resources beneath the phase. In this case, the answer is yes, replace child dates.

Screen Shot 2022-05-18 at 10.43.41 PM

Another way to change dates is to go into the Schedule tab. When clicking on the phase to change, put it into edit mode. This will allow the user to simply drag it to the new dates and duration desired. Users can drag the bar right or left and/or hover over to get the bi-directional arrow to expand the duration. Again, the system will ask to replace the child dates or not.

Screen Shot 2022-05-18 at 10.52.02 PM

Redistributing the Planned Project Hours

Now that the project dates are correct, it is time to go to the Labor tab to work on the planned hours. Going back to the example, the master planning phase was scheduled to begin on January 28 and end on September 30. Its planned hours are 175, which matches the baseline, so no changes are needed.

However, on the Sustainability Planning phase, there are some changes needed because there are no baseline hours saved. The planned hours also look low. To look at this further, users can go into their grid settings and turn on different columns such as Contract and Planned Billing. Doing this, the project manager sees 164 hours, the planned value is coming up at $37,980 but the contract value is $65,000. This will be the first place to start changing planned hours.

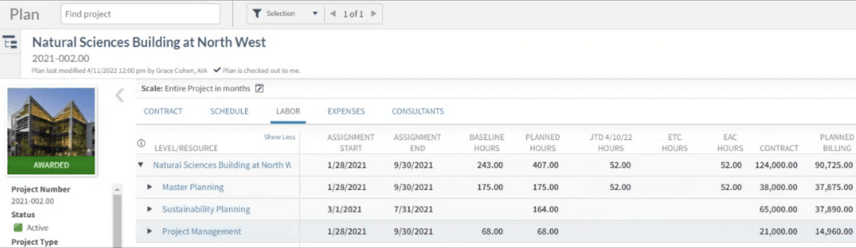

Screen Shot 2022-05-18 at 10.44.17 PM

To do this, go to the phase level and select the ‘kabob’ at the end of the row. Select Redistribute Hours and Change Planned hours. For this example, the project will change those 164 hours to 275. Choose to do this for the entire assignment date range and spread hours evenly over the time period. By choosing to redistribute here, the project manager can now see that the planned hours are 275 and the value is calculated at $63,534 which is closer to the contract value.

Graphical user interface, application

Description automatically generated

Setting a New Project Baseline

Now let’s plan forward or true-up this project plan. In the screenshot above, the master planning phase has a baseline of 175 hours, with 52 hours exhausted but only 77 hours remaining in the Estimate to Complete (ETC). The Estimate at Completion (EAC) hours is settling around 130 hours, and the project manager knows that the project will use most, if not all, of the 175 budgeted hours. So, the hours in the master planning phase will need to be redistributed using the ‘kabob’ at the end of the phase row. This will help push forward the hours and then allow the project manager to fine-tune them as the project progresses.

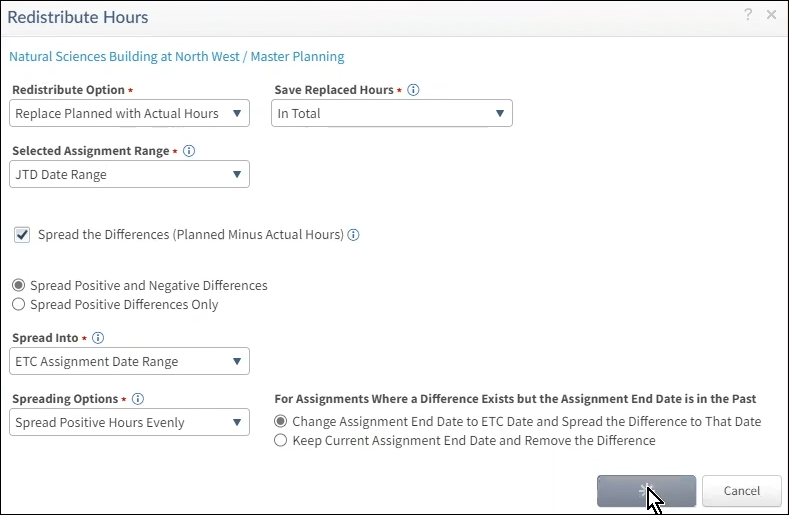

In the redistribute planned hours dialogue box, select the option to replace the planned with actual hours and replace those hours in total. Use the hours from the job to date (JTD) range, choose to spread the differences, and choose to spread both the positive and negative differences in the ETC assignment date range. Then choose to spread the hours evenly.

Graphical user interface, text, application,

Description automatically generated

The project manager would do this for each phase that changes the duration or timeframe. Also, with this example, the project manager would make the changes for the sustainability and project management phases. Once those changes are made, the EAC billing is $104,000 and the contract value is $124,000, which looks like the project will perform rather well. The last step is to publish the plan and start working on the project.

Screen Shot 2022-05-18 at 10.44.37 PM

See Project Plan Changes in Action

While reading about how easy Deltek Vantagepoint makes it for project managers to adjust their project plans, seeing it in action is even better. Click the image below to watch a 16-minute demonstration to understand how Vantagepoint’s Resource Planning makes it very convenient to plan for unplanned project changes.

New call-to-action

Resource Planning Enhancements in Deltek Vantagepoint

Posted by Rana Blair on February 23, 2022

Vantagepoint Resource Planning Enhancements Hero Image

Projects are the lifeline for professional services firms. Deltek Vantagepoint provides applications to support the project planning and resource management activities—Project Planning, Resource Management and Plan Reporting. For those firms who are familiar with Deltek Vision planning, you’re in for a real treat with the enhancements added to Vantagepoint.

The enhancements include the ability to Change Planned Hours, select the ETC / JTD basis in system settings, save Resource View searches for roles, and use Spread Variance to push unused plan hours forward. Let’s dig deeper into these improvements.

Set Plan Inclusion System-Wide

Deltek administrators now have the ability from a system-level to set the inclusion of “in pursuit” project plans on some sort of objective basis. The screenshot below shows how these are automatically set based on the pursuit stages. Keep in mind when the project is awarded, it’s included in those calculations. The beautiful part about Vantagepoint is firms have complete visibility into all the plans, even if the project was not included in those utilization calculations and reports.

VPPlanning-InclusionSettings

The administrator can set different options based on the firm’s preferences. Those include:

  • Never – This means that users can plan but the plan won't be included in the calculations.
  • Always – Selecting this option will always include the plans, regardless of the degree of seriousness or clarity that you have.
  • Set by Project – This is not recommended because it relies on the plan creator to remember to mark the plan for inclusion.
  • Automatically Set Based on Selected in Pursuit Stages – This is the recommended option because it leverages the intelligence of the software to determine the stage of the project and then to automatically determine inclusion into those calculations.
  • Automatically Set Based on Probability – This uses the probabilities set up in the system. Preferences can be set to say anything greater than 50% probability, for example, will be included. Vantagepoint provides a lot of flexibility with this, but this flexibility is from the system standpoint and not each individual plan.

Set Estimate to Complete (ETC) and Job to Date (JTD) Basis System-Wide

While the ability to set and/or change the ETC and JTD was available in Deltek Vision Planning, it was often changed for one purpose or another and could be forgotten to be put back. In Vantagepoint, this is a system setting so that every plan is using the same ETC and JTD basis as shown in the screenshot below.

VPPlanning-JTDSettings

Firms can select the system settings and the basis that works best for them. For example, a firm has a JTD basis through Last Week’s End Date, and that is last Saturday. All the JTD is shown through that date and the ETC date starts the next business day. That allows the firm to have certainty about the JTD figures. If the firm customarily has weekly timesheets that are always completed by the end of the week, this may be a great system setting.

Alternatively, firms can use the Last Timesheet Period’s End Date. If the firm lags a little bit on timesheet entries, utilizing this option so that the JTD information being shown in the plan is that of the last timesheet period will most likely work better. Firms can use this option so that the JTD information shown in the plan is as of that last timesheet week. So, for the first few days of the timesheet period, it's not as accurate, but it's more accurate once that timesheet period is posted and closed.

Rescheduling Plans

Vantagepoint Planning is further enhanced with the ability to reschedule plans. The reschedule ability allows users to either shift or change the duration for the labor tab. This is only for the labor tab in Vantagepoint Planning. Users can pick up the entire date range and move the start date or move it to the finish date.

Like Vision Planning, if the duration is the same, the hours can use the same proportions from the time period. When the duration length is increased, it keeps the same pattern. Conversely, when the duration length is decreased, the system can respread it evenly. But, if the duration shrinks, the system will not like it if unplanned hours fall outside the new duration. In Vantagepoint, this becomes very clear with well-written error messages that pop up for the user.

Change Planned Hours

Changing planned hours is a new function in Deltek Vantagepoint. Project managers can use this functionality to update the planned hours in any timeframe. They can choose to spread the hours proportionally or evenly. For example, a user can take all the hours at the project level or work breakdown structure (WBS) level two and change the planned hours from A to B. This can be done in any timeframe. It can also be done backward and forward using the ETC day. There are a lot of options to change planned hours in Vantagepoint Planning.

The screenshot below shows the new Redistribute Hours menu in Vantagepoint where users can change the planned hours.

VPPlanning-RedistributeHours

Replace Planned Hours with Actual Hours

The next enhancement is the ability to replace planned hours with actual hours. This functionality allows users to choose the replacement of hours for a specific date range or across all dates as well as choose to calculate on a weekly, monthly, or total basis. An example is shown below.

VPPlanning-ReplacePlanwithActualHours

Spread Variance

The ability to spread the variance between planned and actual hours can be done in several ways over the time periods selected. It allows the user to control how they spread the differences between actual and planned as well as choose different date ranges. The date range can be a specific date range, an entire date range, or just a short amount of time. The project manager can choose to spread the hours including the negatives or just limit to the positive differences. The variance can be spread evenly or proportionately.

The biggest enhancement is that now this setting is directly available in the plans in Vantagepoint as opposed to another menu or area of the system, providing better visibility, as shown below.

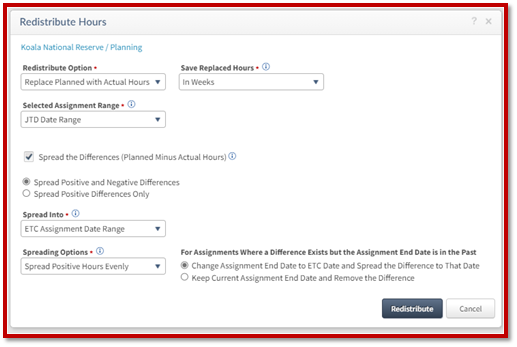

VPPlanning-SpreadVariance
